HIGH COURT OF CHHATTISGARH
Sanjay K. Agrawal, J.
Mrs. Poonambala Jaiswal, W/o Late Shri Anil Jaiswal - Appellant
Vs.
State Of Chhattisgarh - Respondent
Civil Revision No. 26 of 2017
Decided On : 29-01-2025
(A) Indian Contract Act, 1872 - Section 62 - Chhattisgarh Madhyastham Adhikaran Adhiniyam, 1983 - Civil Revision against Award rejecting claim for refund of security amount and damages - Petitioners completed 9 out of 11 roads; foreclosure of contract accepted due to naxal issues - Court held that previous contract was rescinded and Petitioners entitled to recover withheld amounts. (Paras 2, 6, 12, 13)
(B) Contract Law - Rescission and its effects - Rescission requires mutual agreement; unilateral termination is invalid - Court emphasized that previous contract was not substituted, thus allowing recovery of certain amounts. (Paras 9, 10, 12)
Facts of the case:
Petitioners were awarded a contract for rural road construction but could not complete one road due to naxal problems. They sought foreclosure of the contract, which was accepted, but later faced deductions and penalties.
Findings of Court:
The court found that the Petitioners were entitled to recover the withheld amounts of Rs.7.809 Lakh and Rs.17.62 Lakh, but not for maintenance or damages.
Issues: The main issues were whether the contract was validly rescinded and if the Petitioners were entitled to the withheld amounts.
Ratio Decidendi: The court ruled that the contract was rescinded due to mutual agreement and the Petitioners were entitled to recover certain amounts withheld by the Respondents.
Result: Award dated 22.11.2016 set aside; Civil Revision allowed in part.
Order :
1. This Civil Revision is directed against the Award dated 22.11.2016 passed by Chhattisgarh Madhyastham Adhikaram, Raipur ('Adhikaran' for brevity) in Reference Case No.9/2014, rejecting the claim of the Petitioners for refund of security amount, cost of maintenance, damages and interest etc.
2. The aforesaid challenge has been made on the following factual background of the case:-
(i) In September, 2008 the State of Chhattisgarh had floated Notice Inviting Tender for construction and maintenance of 11 Rural Roads under Pradhan Mantri Gram Sadak Yojana, Package No. CG-15-82 of District Rajnandgaon for the year 2008-09. As per the tender, the total amount of contract value was Rs. 843.32 Lakh and the contract period was for 12 months for completion of work till 14.10.2009.
(ii) The original Petitioner Late Anil Kumar Jaiswal being the lowest bidder was awarded the contract and the Agreement was executed between the parties on 1.10.2008 and the accepted value of work was Rs. 659.88 Lakh. The price of the contract was further revised to Rs. 570.61 Lakh. The extension was granted for completion of work till 15.1.2010 on account of naxal problem in executing the work.
(iii) The Petitioners completed 9 out of 11 roads, as one road i.e., Chhuikhadan to Budhanbhat, was already completed by the Public Works Department. However, the road relating to 'Tendubhata to Sarodhi' could not be completed on account of naxal problem. Hence, the Petitioners requested the Respondents for the foreclosure of the contract in light of clause 55.1 of the Agreement. The Executive Engineer wrote a letter to the Superintending Engineer for the foreclosure of the contract under clause 55.1, pursuant to which the Superintending Engineer in turn also wrote a letter (Annexure P-3/4) to the Chief Executive Officer for the foreclosure of the contract under clause 55.1 of the Agreement.

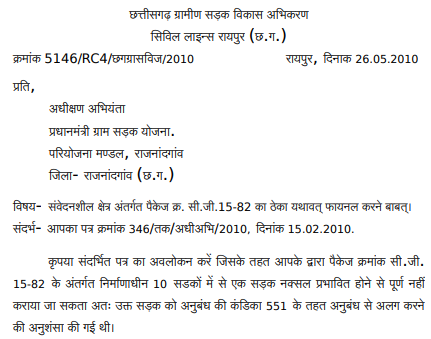

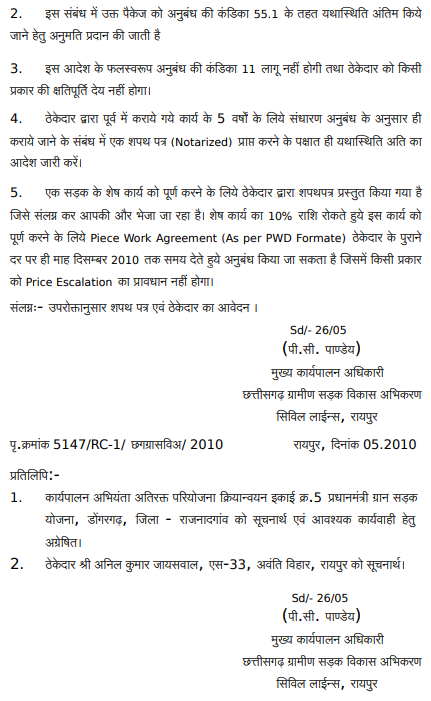

(iv) On 26.5.2010 (Ex. P-3), permission was granted by the Chief Executive Officer for the foreclosure of the contract for package No.15-82 as per Clause 55.1 of the Agreement with certain conditions that the Petitioners will complete the construction of the said road under a separate piece-rated work agreement as the main agreement was agreed to be foreclosed.
(v) Ultimately, on 28.5.2010 (Ex. P-3/2) the work was completed by the Petitioners and Work Completion Certificate was issued by the Executive Engineer-cum- Member Secretary, PUI-5, Pradhan Mantri Gram Sadak Yojna. Thereafter, the Petitioners requested for finalization of the final bill amounting to Rs.7,80,917/- which could not be finalized by the Respondents, but the Respondents issued notice to the Petitioners for recovery of Rs.28.211 Lakh towards imposed liquidated damages and penalties by deducting the payment of the final bill and also withheld the security deposit. On 8.10.2012 (Ex. P-7), the Petitioners raised their objection against the said recovery. However, on 27.4.2013 (Ex. P-1), the Chief Engineer, Pradhan Mantri Gram Sadak Yojna, rejected the claim of the Petitioner under clause 24 (Dispute Redressal Forum) of the Agreement.
(vi) Eventually, the aforesaid reference case under Section 7-A of the Chhattisgarh Madhyastham Adhikaran Adhiniyam, 1983 was filed by the Petitioners before the Adhikaran claiming amount of Rs.81,569 Lakh under different heads. Respondents filed their Written Statement before the said Tribunal stating inter-alia that the Petitioners are not entitled for the said claim. However, the Respondents accepted the letter dated 26.5.2010 whereby permission was granted for the foreclosure of the contract for package No.15-82 as per clause 55.1 of the Agreement and only pleaded that the Petitioners are responsible for completing the work with a delay of 8 months.
(vii) However, the Adhikaran, by the impugned Award dated 22.11.2016, after hearing the parties, rejected the claim of the Petitioners holding that the Petitioners have failed to complete the work of one road i.e., Tendubhata to Sarodhi,


Rescission of a contract requires mutual agreement; unilateral termination is invalid. The court ruled that the previous contract was rescinded, allowing the Petitioners to recover certain withheld a....
State cannot recover amounts from contractors without prior adjudication; such actions violate principles of natural justice.
The court upheld the principle of enforcing contract terms regarding termination and forfeiture of deposits due to delay in work completion. The recovery of additional expenditure was subject to a fr....
A contract termination must adhere to principles of natural justice, including the right to a personal hearing, and disputes regarding breaches must be adjudicated by an independent forum rather than....
