judgment-img

2026 Supreme(Mad) 163

IN THE HIGH COURT OF JUDICATURE AT MADRAS
N.ANAND VENKATESH, J.
M/s. Sivashankar & Co., Rep.by its Proprietor D. Sivashankar - Petitioner
Versus
The Divisional Railway Manager, Chennai Division, Southern Railway Chennai – Respondent
Arb.OP(Com.Div).No.630 of 2022
Decided On : 13-02-2026

Advocates Appeared:
For the Petitioner: Mr. J. Srinivasa Mohan for M/s.TVJ Associates
For the Respondents: Mr. K.S. Jayaganesan, Senior Counsel

The court held that a contract's termination after expiration is unlawful, necessitating the return of forfeited amounts when unjustified actions take place.

Headnote:(A) Arbitration and Conciliation Act, 1996 - Section 34(1) - Challenge to arbitral award regarding unlawful contract termination - The termination of contract was held illegal and unjustified, resulting in the return of forfeited amounts - Contractual claims and counterclaims were analyzed, and specific claims were awarded. (Paras 25, 27, 37)

(B) Contract Law - The court addressed whether a contract can be canceled after its expiration and the implications of justified delays on contractual obligations - The court ruled that a termination without a subsisting contract is invalid. (Paras 10, 21)

Facts of the case:
A petitioner challenged the arbitral award following the termination of a contract for constructing a foot over bridge, where the respondent forfeited performance guarantees and deposits based on poor performance.

Findings of Court:
The court concluded that the termination notice was invalid as the contract had already expired, deeming the forfeiture of deposits unlawful.

Issues: The primary issues were the validity of contract termination after expiration and justification for not awarding specific claims due to alleged breaches.

Ratio Decidendi: The court ruled that without a valid termination, claims associated with the contract must be compensated, emphasizing that unjustified termination leads to the return of forfeited amounts.

Result: The Arbitration Original Petition is allowed, with claims awarded in favor of the petitioner.

Table of Content
1. introduction and factual background of the case. (Para 1 , 2)
2. counter claims made by the respondent. (Para 3 , 4)
3. legal grounds for challenging the arbitral tribunal's award. (Para 5 , 6)
4. consideration of contract termination and extension. (Para 8 , 10 , 11)
5. observations regarding the legitimacy of contract termination. (Para 15 , 21 , 22)
6. analysis leading to the conclusion of the case. (Para 25 , 26)
7. final claims determination and awards. (Para 27 , 28 , 34 , 36)
8. consideration of claims related to loss of profit. (Para 30 , 31 , 32)

ORDER :

N.ANAND VENKATESH, J.

This Arbitration Original Petition has been filed challenging the award dated 27.3.2022 passed by the Arbitral Tribunal under Section 34 (1) of the Arbitration and Conciliation Act, 1996 , [hereinafter referred to as 'the Act'] .

2.The petitioner and the respondent entered into an agreement dated 27.3.2017 for work relating to provision of new foot over bridge at Chennai, Egmore. This was for platforms 2 to 11. The Letter of Acceptance was issued on 7.11.2016 and the duration of work was fixed as 12 months. However, extensions were granted till June 2020. Ultimately, a notice of termination dated 30.09.2020 was issued by the respondent under the General Conditions of Contract (GCC) 62(1) and 16(4)(f). Pursuant to the same, the Earnest Money Deposit (EMD), Performance Guarantee (PG) and Security Deposit (SD) were forfeited and certain claims made by the petitioner was rejected. The dispute was referred to the Arbitral Tribunal and the claimant made the following claims:

(a) To declare that the termination order dated 30-09-2020 is unlawful and also the termination has been done without currency.

(b) Direct the Respondent to release the Performance Guarantee amount of a sum Rs. 16,62,557/- .

(c) Direct the Respondent to Refund the EMD of Rs. 2,82,400/-.

(d) Direct the Respondent to Refund the Security Deposit of Rs. 13,45,026/-.

(e) Direct the Respondent to pay the Price Variation Clause Amount of a sum of Rs. 17,63,411/-.

(f) Direct the Respondent to pay the GST Amount of a sum of Rs. 14,26,327/-.

(g) The Claimant is entitled to cost of Stock at site of a sum o Rs.4,50,000/-.

(h) The Claimant is entitled to loss of amount incurred in Idling of men and Machinery of sum of Rs. 1,40,000/-.

(i) The Claimant is entitled to overhead charges and establishment charges incurred of a sum of Rs.6,76,000/-.

(j) The Claimant is entitled to cost of 2.5 MT Finished steel structure of a sum of Rs.2,96,000/-.

(k) The Claimant is entitled to loss of profit at 10% on the balance work of Rs. 2,89,54,459/- amounting to Rs.28,95,446/-.

(l) The Claimant is entitled to Rs. 15,06,047/- payable towards the Interest and charges paid by the Claimant to banks and others.

(m) The respondent is liable to pay compensation 20,00,000/-for the agony endured and which continues till date due to the wrongful termination of the contract.

(n) The claimant is entitled to interest on the claims.

(o)The respondent is liable to bear the cost of arbitration.

3.The respondent filed statement of defence and justified the termination of contract and forfeiture of EMD, PG and SD. The respondent sought for counter claims to the total tune of Rs.2.44 Crores. The respondent also sought for the rejection of the claim made by the petitioner.

4.The Arbitral Tribunal instead of framing issues thought it fit to deal with each claim made by the petitioner and the counter claim made by the respondent. On considering the facts and circumstances of the case and the documents relied upon by both sides, Claim Nos.5 and 6 alone were awarded. Insofar as the counter claims are concerned, the majority members held that the respondent is entitled for Counter Claim Nos.1 and 2 and rejected Counter Claim Nos. 3 to 5. The summary of the award is tabulated hereunder:

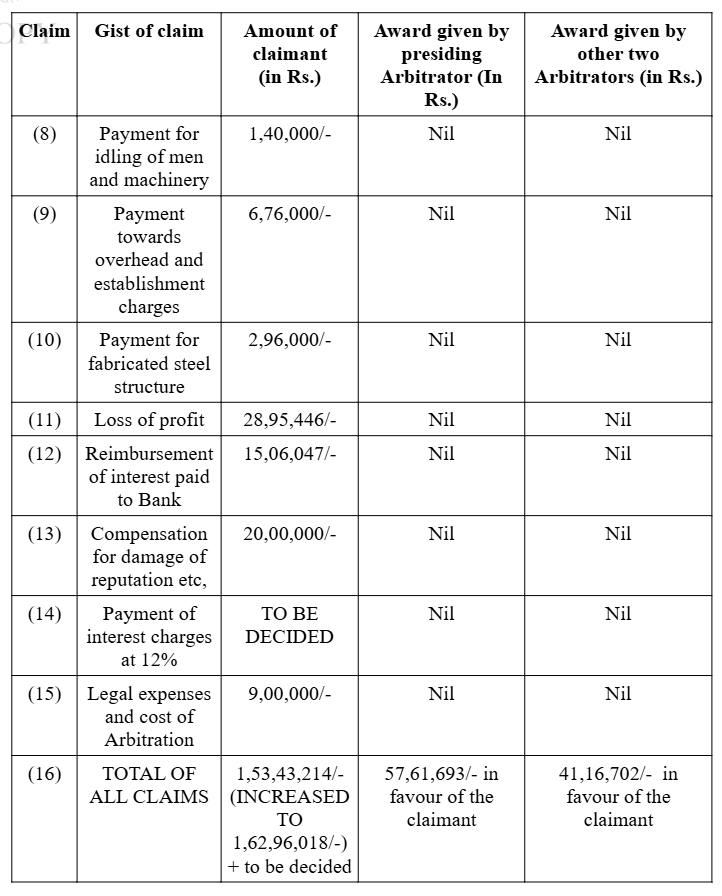

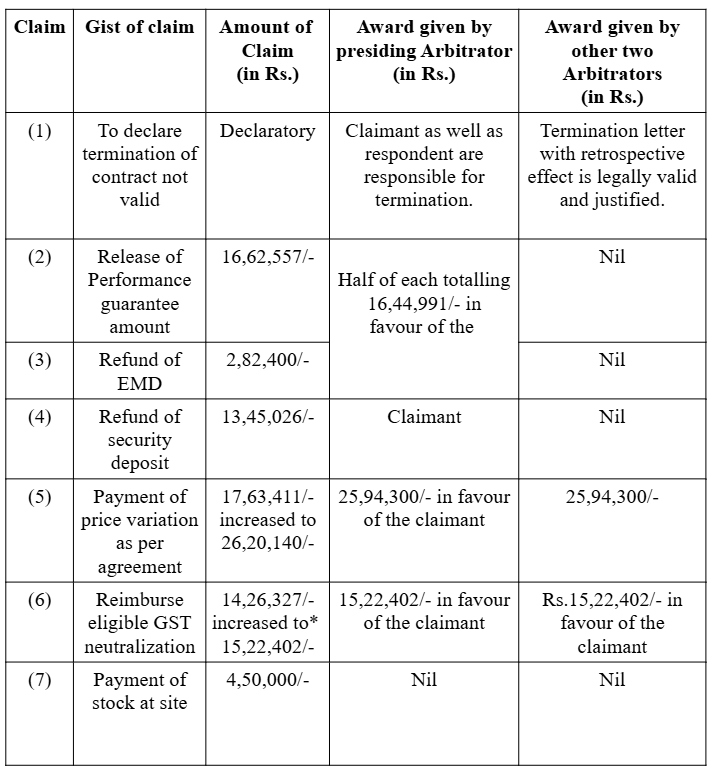

48.1 Claims of Claimant :

*Increased by the claimant through his submission at CD-4.

49.COUNTER CLAIMS OF RESPONDENT:

5.Aggrieved by the above award passed by the Tr
