IN THE HIGH COURT OF KERALA AT ERNAKULAM
Sathish Ninan, Johnson John, JJ.
State Of Kerala Represented By The Secretary To Government, Water Resources Department And Ors. – Petitioners
Versus
P.P.Thomas And Ors. – Respondents
RFA No. 533 of 2013
Decided On : 22-08-2024
Contract - Breach of Contract - MDSS Clauses - The court interpreted the provisions of the MDSS and the PWD Schedule of Rates, emphasizing the contractor's right to claim damages for delays caused by the defendants, leading to a decision in favor of the plaintiff.
Fact of the Case:
The plaintiff, a contractor, entered into an agreement with the defendants for construction work but faced significant delays due to the defendants' failure to hand over the work site and provide necessary materials, leading to a lawsuit for unpaid work.
Finding of the Court:
The court found that the defendants breached the original contract by delaying the handover of the work site and failing to supply materials, thus entitling the plaintiff to damages and unpaid amounts as per the PWD Schedule of Rates.
Issues: 1. Did the defendants breach the original contract? 2. Are the supplemental agreements valid and enforceable? 3. Is the trial court's judgment legally sustainable?
Ratio Decidendi: The court held that the defendants' failure to perform their contractual obligations constituted a breach, and the supplemental agreements were void due to economic duress exerted on the plaintiff.
Result: The appeal is disposed of with modifications to the interest awarded, affirming the trial court's decision in favor of the plaintiff.
JUDGMENT :
JOHNSON JOHN, J
The appellants are the defendants in O.S. No. 35 of 2005 on the file of the Sub Court, Muvattupuzha.
2. The suit is for declaration and realization of unpaid value of works conducted by the plaintiff. The plaintiff is a Contractor who entered into an agreement with the defendants on 27.11.1995 for the construction of Mulakulam Branch canal from CH.4400 metres to 5650 metres, including cut and cover and cross drainage works. The agreement was executed after the acceptance of the tender on 25.11.1995. The agreement incorporated MDSS as the main part of the contract with the PWD Schedule of Rates of 1992.
3. As per the agreement, Rs.3,69,72,007/- was the probable amount of contract and the time fixed for performance was 12 months. Even though, the plaintiff made necessary arrangements for the execution of the work in time, the defendants failed to hand over the work site within two months as per the terms in the agreement. The time for handing over the work site expired on 27.01.1996 and the time fixed for performance expired on 27.01.1997. The defendants handed over possession of the work site to the plaintiff only on 17.10.1997 and the second defendant approved the initial level measurement of earth work excavation only on 23.12.1997.

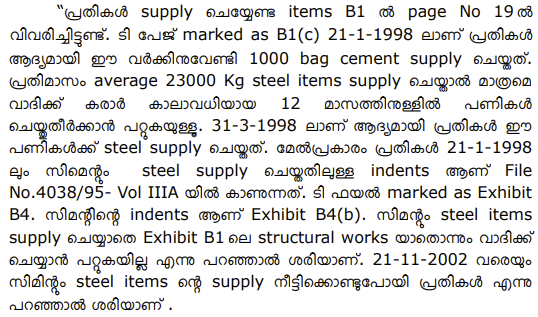

4. Though, the defendants handed over possession of the work site on 17.10.1997, the standing trees, electric and telephone posts in the alignment of the canal were removed by the defendants only after 23.04.1998. The design, drawings and structural particulars were supplied to the plaintiff only during the last week of June, 1998. The initial measurements for blasting and removal of hard rock were approved by the second defendant only on 27.09.1998. The defendants failed to supply cement and steel items as agreed. The defendants also delayed payment of part bills and effected unauthorized and illegal recoveries from the bills.
5. As per clause 59 of MDSS, the plaintiff is entitled to claim damages for the delay caused by the defendants and for payment at market rates. Since the Government banned excavation of sands from the source of supply specified in the contract during 2001, the work was delayed and the plaintiff had to procure sand from distant places by incurring huge transportation expenses, and the same was not reimbursed by the defendants. The work was completed on 30.12.2002, after 3 1/2 years from the coming into force of 1999 PWD Schedule of Rates. The defendants were withholding the payments due to the plaintiff and they exerted undue influence and coercion on the plaintiff to sign supplemental slips for extension of time.
6. It is stated that the supplemental slips are vitiated by undue influence, coercion and duress and were for unjust enrichment of the defendants and are unauthorized and illegal. It is stated that the plaintiff carried out the works beyond 27.01.1997 and therefore, the plaintiff is entitled for market rates as per 1996 and 1999 PWD Schedule of Rates.
7. The main contentions in the written statement of the defendants are that, the defendants are not responsible for the delay in completion of the work. Even though, the site was handed over to the plaintiff only after 23 months from the date of execution of the agreement, the plaintiff was ready to do the work as per the conditions in the original agreement and he did not raise any objection when the site was handed over on 17.10.1997. The measurements for earth work were taken and approved by the Department as per rules, and the Department was also prompt in supplying materials to the plaintiff. As per the agreement, the plaintiff is not entitled to claim any extra costs for purchasing materials from the open market. The payments were made to the plaintiff subject to the availability of letter of credit and funds considering seniority of bills. There was no illegal or unauthorized recovery as alleged by the plaintiff. It is stated that the plaintiff signed the supplemental agreements without any c
Central Inland Water Transport Corpn. v. Brojo Nath Ganguly
K.N. Sathyapalan v. State of Kerala
M/s. Ambica Construction vs. Union of India (2006) 12 SCALE 149
M/s. Associated Construction v. Pawanhans Helicopters Pvt. Ltd.
The court established that contracts signed under economic duress are void, emphasizing the importance of equal bargaining power in contractual agreements.
The court upheld the binding nature of the contract, ruling that the Plaintiff's claims were untenable due to failure to exercise contractual options and were barred by limitation.
The court upheld that delayed payments must be compensated with interest, emphasizing that the appellants’ claims of irregularities were unsubstantiated and did not impede the contractors' right to r....
Point of law: When the appeal is presented in terms of Section 96 CPC and when this Court is considering this appeal not only as a last Court of fact but also in terms of law, it is open for the appe....
Contractual obligations regarding delayed construction projects must consider the contractor's contributions to delays and enforceability of claims under economic duress.
Contractors cannot claim damages for delays caused by their own inaction or failure to meet contractual obligations, even if land acquisition delays occur.
Escalation of contract rates is permissible when delays are not due to the contractor's fault, allowing for additional payment for work done after significant delays.
The court upheld that a party may be compensated for work done despite absence of a written contract when the other party benefits, reinforcing principles of unjust enrichment under Section 70 of the....
The court affirmed that a contractor's claims for delays caused by defendants were valid, and it has the discretion to adjust interest rates based on economic conditions.
